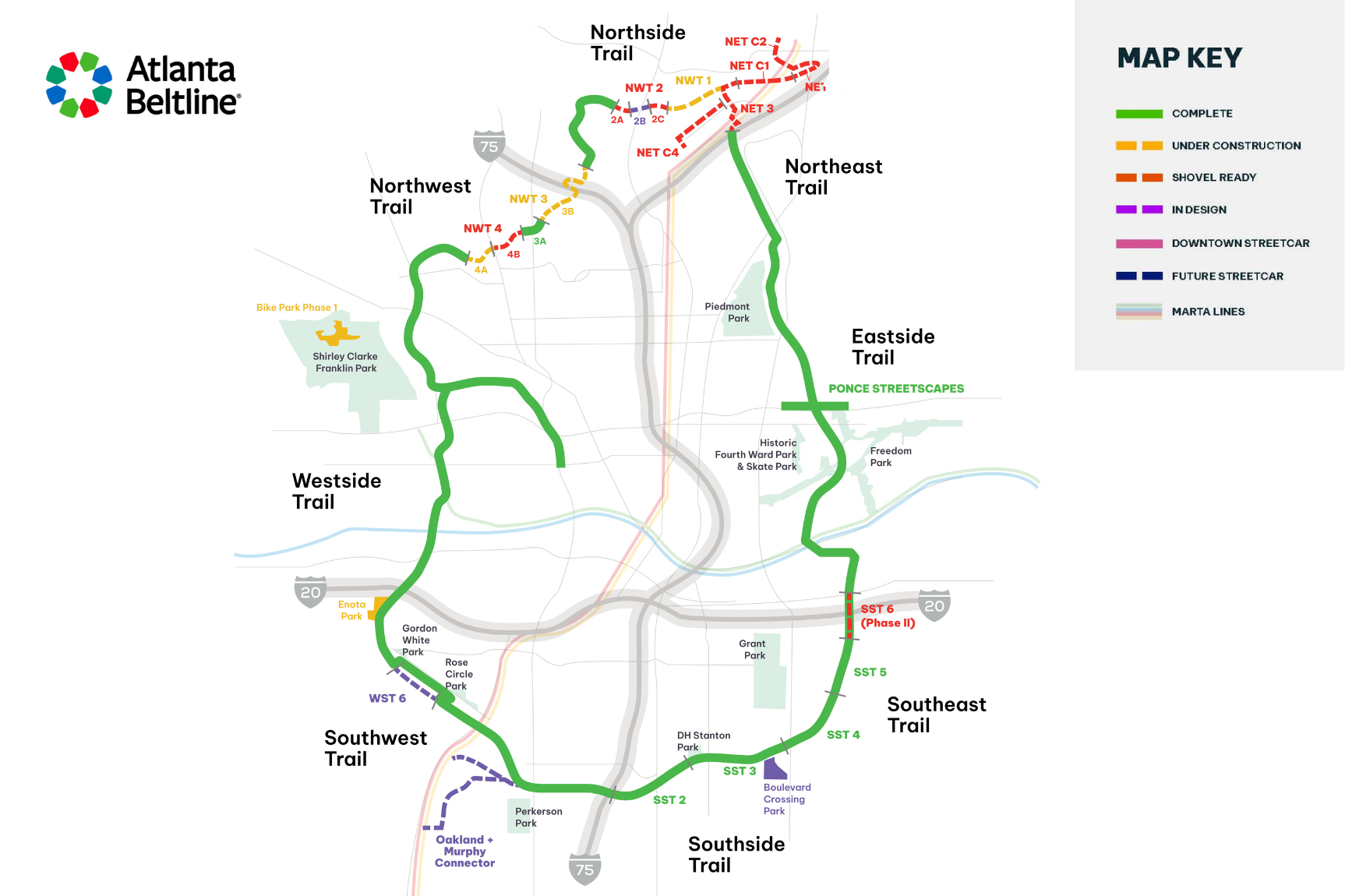

Atlanta Beltline Design and Construction Updates: May 2026Atlanta Beltline Design and Construction Updates: May 2026
Below you will find recent updates and photos of each of our Atlanta Beltline projects in design or construction for May 2026.
Design & Construction
Parks & Trails
JUNE 15, 2026
Below you will find recent updates and photos of each of our Atlanta Beltline projects in design or construction, along with links to get more general information about each project. These projects play a pivotal role in furthering the Atlanta Beltline vision to be the catalyst for making Atlanta a global beacon for equitable, inclusive, and sustainable city life.
Note that some projects have been removed to focus on monthly progress, and project expectations are subject to change due to unforeseen conditions. For the latest updates, visit their project pages.
Reminder: Active construction sites are dangerous, and entering the trail or park construction sites could result in serious injury. We understand that the community is excited about new trail sections—so are we! Operating heavy equipment, incomplete railings, security cameras and lighting not yet operational, and contaminated soils are some of the many reasons why job sites are hazardous. Thank you for your patience while we work toward their official openings.
Current Projects
1. Northeast Trail - Segment 3 and Connector Trails
Northeast Trail Segment 3 and Connector Trails:This federally funded portion of trail includes the mainline trail of the Atlanta Beltline 22-mile loop, called Northeast Trail – Segment 3, as well as connector trails to MARTA Lindbergh Center station, PATH 400, and to the Armour-Ottley district. The $25MRAISE Grant agreementwas executed in January and GDOT issued a notice to proceed to the Beltline. The team issued aninvitation to bidfor construction procurement in April, with construction expected to mobilize this summer. This is a long and complex project, one of the Beltline’s largest, and the expected construction duration will be 42 months.
2. Southside Trail Segments 2+3

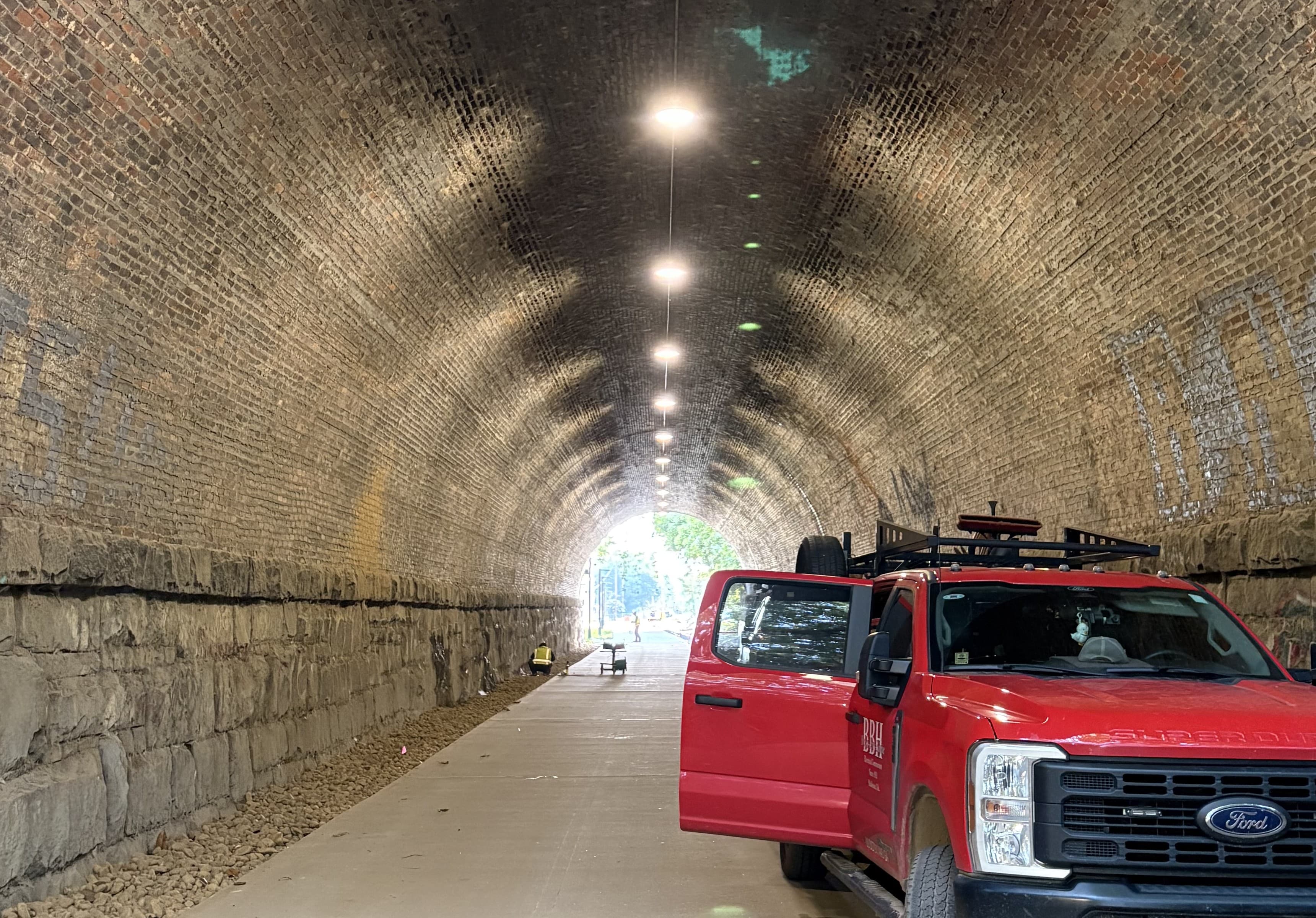

Lighting and concrete trail complete passing through historic rail tunnel. (Photo Credit: ABI Staff)
010203
03
Southside Trail Segments 2+3:This 1.9-mile section runs from west of I-75/85 to Boulevard and was released for construction in May of 2024. While some unexpected environmental cleanup work has delayed the schedule, the trail will be open and accessible during the FIFA World Cup 26™. Mainline trail pours and tie in work at the Milton and Boulevard crossings are complete, with the McDonough access point in a final stage of construction. Punch list, follow on work, and other landscaping work will continue after the trail is open. Additional landscaping, including the addition of trees and shrubs, will continue in the cooler Fall weather through the Spring of 2027. We will continue to keep the community informed on progress.
3. Southside Trail - Segments 4 + 5
Southside Trail – Segments 4+5: This trail segment runs from Boulevard to Glenwood and is 1.2 miles long. This trail segment runs from Boulevard to Glenwood and is 1.2 miles long. A ribbon cutting ceremony was held on April 16. Railing installation is underway at United and is expected to be completed by mid-June. The contractor continues to work on punch-list and close-out items.
4. Westside Trail
0102
02
Westside Trail – Segment 6:This trail connects the Westside Trail at Lawton Street SW to the Westside Trail at Ralph David Abernathy Boulevard/White St. This 0.6-mile section of trail is open, but is a sidewalk connection, diverted off the rail corridor with ramp connections to an adjacent sidewalk. This project will construct a trail connection on the rail corridor. The 90% design milestone has been reached. In January, we began trimming landscaping, adding new gravel, and putting up temporary poles in this corridor for lighting and cameras on the interim trail until the permanent trail construction work is mobilized. Construction of a new Beltline trail at this location will likely start in the fall of this year, after construction permitting and solicitation of a contractor is complete. The project is tentatively scheduled to be completed in early 2028. Landscaping work will extend into 2028.
5. Northwest Trail - Segment 1
0102
02
Northwest Trail – Segment 1:This 0.8-mile section runs from the west side of Peachtree Parks Apartments south along Peachtree Creek. The apartment side of the trail became available to Peachtree Park residents for use in April. Due to bridge engineering issues, construction of the bridge at Peachtree Creek and the completion of the northern elevated trail connecting to Kinsey Court will push into Fall of 2028. All infrastructure associated with the trail is now complete. Elevated trail concrete pours are complete for the footings and piers.
6. Northwest Trail - Segment 2
Northwest Trail – Segment 2:This 0.7-mile segment starts at the southeast corner of Bobby Jones Golf Course and runs east along Colonial Hills Circle. Design plans are complete, and real estate acquisition and easement work is ongoing. The Beltline has signed an agreement with GDOT for the construction of a new tunnel passing under Peachtree Street for the trail. GDOT is actively working on procuring real estate agreements with property owners for the bridge work. Portions of this segment – section 2A and 2c - are shovel-ready, with all real estate work complete, and section 2A starting at Bobby Jones will go out to bid in early June.
7. Northwest Trail - Segment 3
0102
02
Northwest Trail – Segment 3:This segment runs 1.2 miles from Trabert Avenue near Monday Night Brewing’s parking lot to Tanyard Creek, crossing under I-75. The first portion, between Trabert and Northside (Section 3A), is complete and open. A contractor has been hired for Section 3A, with construction mobilization expected this summer.
8. Northwest Trail - Segment 4
0102030405
05
Northwest Trail – Segment 4:This 0.9-mile segment links English and Culpepper to the Monday Night Brewery parking lot at Trabert. We have split Segment 4 into Section A and Section B to provide opportunities for a smaller construction firm to bid on Section B. Construction on Section 4A is underway, with a completion date expected in August of 2027. Trail concrete pours are in progress, along with foundations and columns for the bridge at the railroad crossing. Bridge redesign and all real estate work required to complete the trail is complete.
9. Beltline Connector Trails + Access Points
Oakland City MARTA Station + Murphy Connector Trail:This connector trail is expected to stretch 1.31 miles in total, beginning at the existing Southwest Trail access point at Allene Ave SW and splitting into two sections. Design is underway, with the 60% set under review and 90% design expected by early fall. Coordination is ongoing with the Atlanta Department of Transportation on the Allene Intersection, which is a Moving ATL Forward project. A site walk was held in April, and extensive real estate coordination is in progress. Construction is scheduled to begin in early 2027, with trail completion expected in mid-2028 and landscaping work extending into early 2029.
10. Enota Park
0102030405
05
Enota Park:An eight-acre park under construction on the west side of Atlanta, Enota park has been broken into three sections: upper, middle, and lower. In the upper parcel, boardwalk construction, streambank restoration, and the overlook of the stream are complete. Kudzu removal and grading work for final landscapes and the lawn are ongoing. Handrails are in final approval. In the middle parcel, stormwater and grading work is complete with stair and walkway concrete to be completed by June. In the lower parcel, the handrails, pavilion, and walls are ongoing. Building shells are complete, with interiors in progress. Trees Atlanta began planting trees in April, and the team aims to complete the park by the late summer or early fall of 2026.
11. Bike Park at Shirley Clarke Franklin Park
01020304
04
Shirley C. Franklin Park (formerly Westside Park) – Mountain Bike Trail and Pump Track:Phase 1 of this project will ultimately create a world-class asphalt pump track facility, jump lines, a bicycle playground, hiking trails, and a skills course designed for riders of all ages and abilities. Construction on this phase is underway and on schedule, with bike park elements and finer grading in progress. Fundraising is ongoing to fund the entire project and all desired elements and phases of work, with Phase 2 consisting of a 2.25-mile mountain bike trail for various skill levels, and hiking trails. The design of Phase 2 of the Bike Park is being contracted currently, with design work expected to start in late June or early July.
Trail Lighting and Camera Projects
Signage and Wayfinding
Design is in progress on a comprehensive signage and wayfinding update for the Beltline 22-mile loop. This project includes new regulatory, wayfinding, identification, and specialty signage, including signage for art, donor recognition, and the Beltline Arboretum. Etiquette messaging banners have been installed along the trail in many locations. Crews have started installing branded crosswalks around the 22-mile loop to improve the visibility of the crossings. The crossings at Westminster Drive, Kirkwood Avenue, and on the Westside Trail at Joseph E Boone Boulevard, Mayson Turner Road, and Law Street are complete. Additional locations are planned at Marietta Boulevard, West Marietta Street, and Kennesaw Drive before the FIFA World CupTM. Installation will continue across completed trail sections in the next few months and will be incorporated into future segments of the Beltline as they open.
Pictured from left to right: First crosswalk installation complete at Westminster Drive. A biker rides past an etiquette messaging sign on the Northeast Trail. (Photo Credit: ABI Staff)
