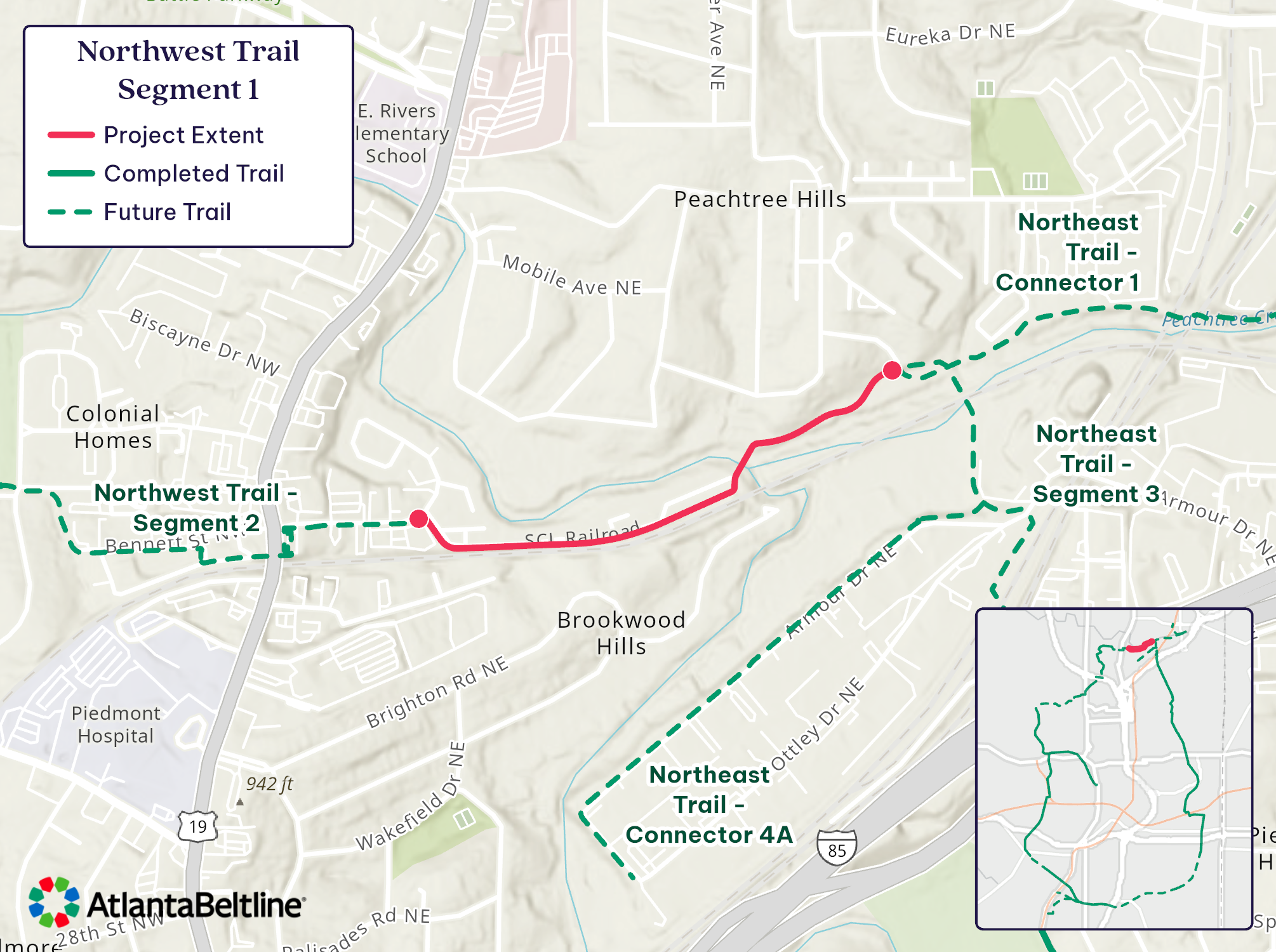

Northwest Trail-Segment 1
This section of trail is 0.8 miles in length, beginning at the western edge of Peachtree Park Apartments and running south along Peachtree Creek to Kinsey Court.

This segment is closed for construction. Trespassing on active construction sites is prohibited.




The full Northwest Trail will run for 4.3 miles from the terminus of the Westside Trail to the beginning of the Northeast Trail.
Project Status
The trail on the north and south sides of Peachtree Creek is fully under construction. Progress includes the completion of 90% of all the retaining walls as well as 90% of the underground storm. The trail on the south side of Peachtree Creek running through Peachtree Park Apartments is now 50% poured, and we are working on curbs and sidewalks tying into the existing infrastructure in the apartment complex. The bridge superstructure is complete, and we have poured three spans of elevated trail on the north side of the creek. We expect to pour the bridge deck by mid-August. We are currently on schedule, and the project is targeting completion in June of 2026.
Project Timeline
June 2022: Survey work began.
August 2022: Prioritized alignment announced for the Northwest Trail.
October 2022: Survey work completed.
January 2023: 60% design completed.
October 2023: Reeves Young hired as Construction Manager at Risk.
January 2024: 90% drawings completed.
May 2024: Reeves Young began construction activities.
Fall 2024: Full construction began.
June 2026: Target completion date.
