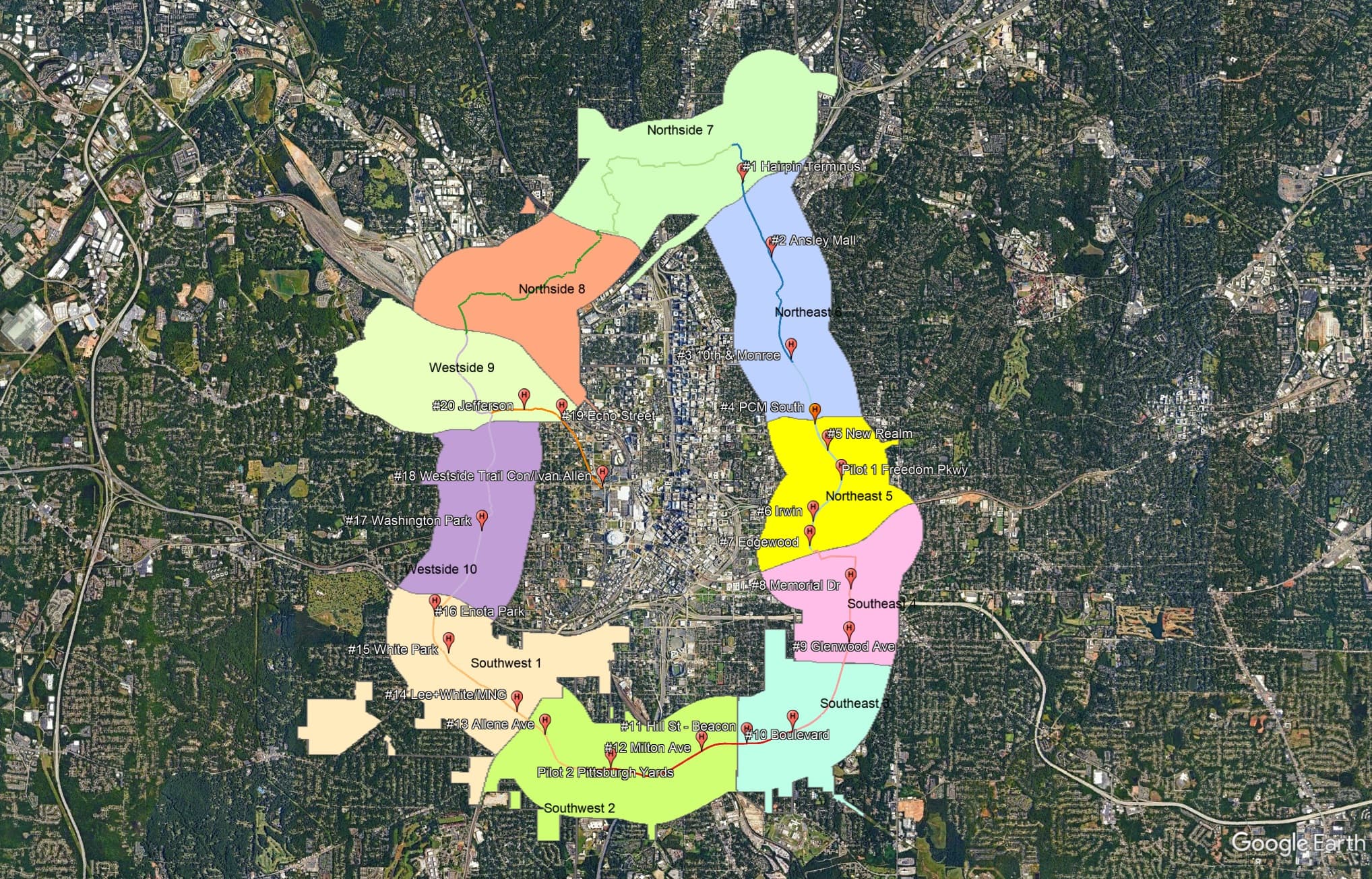

As the Beltline enhances mobility through infrastructure, this Smart Corridor project includes installing 22 smart hubs of technology across the 18 miles of open Beltline trail. These sites will all include public Wi-Fi access zones and a digital wayfinding kiosk.

Near the Marketplace locations additional technologies will be piloted including smart trash cans and camera visualization AI technology. The Pittsburgh Yards access point and Freedom Parkway Marketplace locations will also include the Nourish+Bloom autonomous grocery container concept and EV Charging stations somewhat adjacent to the sites.

Project Status

Work is underway on multiple locations as our subcontractor eX2 Technology and their subcontractors continue to advance site development and implementation work for our initial digital access and smart corridor project. Updates include:

  • The Freedom Parkway site is mostly complete. Permanent power is nearing completion. Final devicing work is also underway to enable public Wi-Fi and camera visualization technology. Punch list items for the Nourish + Bloom autonomous grocery are progressing including the recent install of the ADA ramp and the interior build-out to prepare for opening.

  • The Irwin, Pittsburgh Yards, and Glenwood locations are nearing completion of permanent power. Final devicing work is underway to include public Wi-Fi and camera visualization technology at the Irwin and Pittsburgh Yards sites.

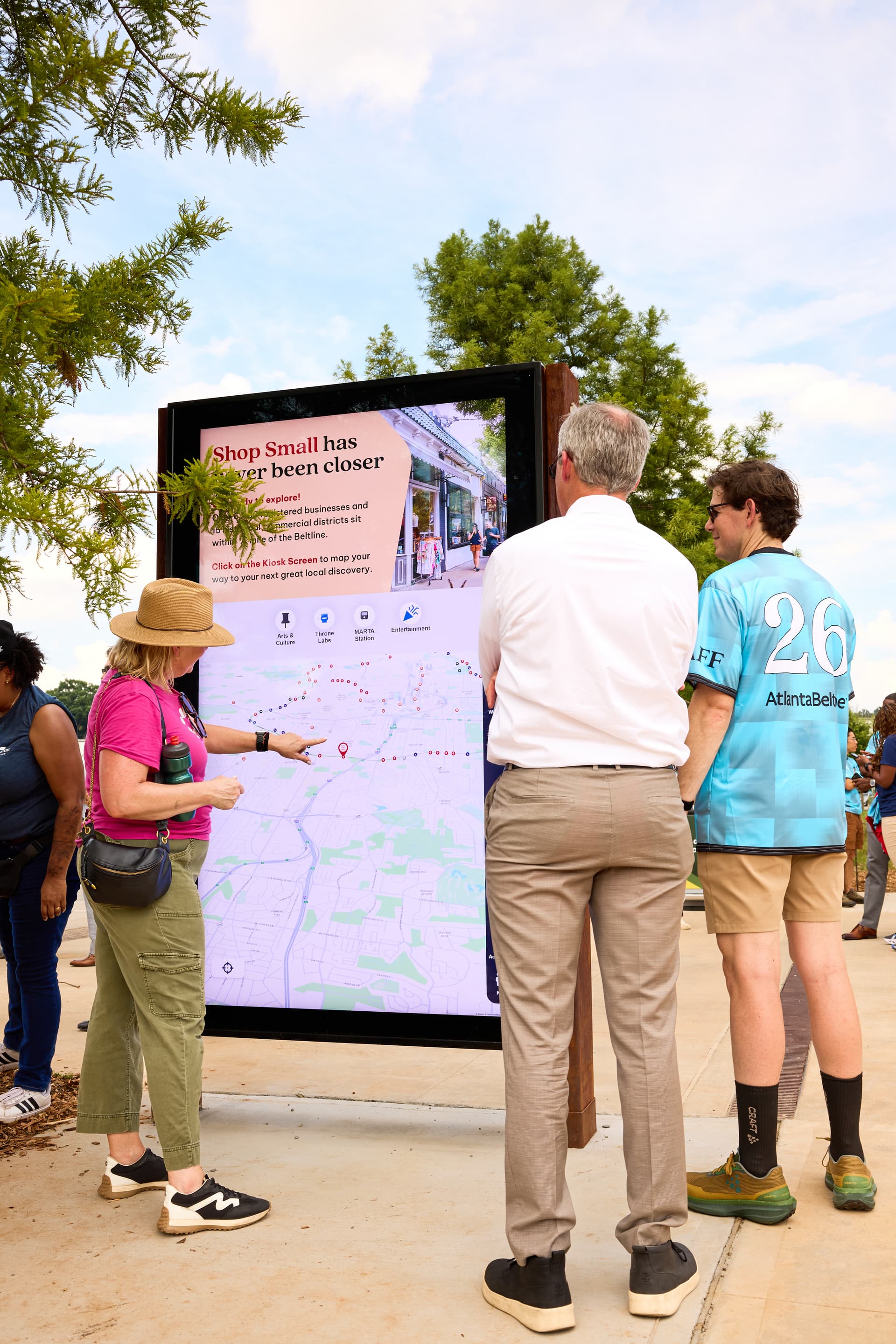

  • The Washington Park location has received permanent power. The digital wayfinding kiosk has been set, and the concrete work has been complete. Utility work is also now complete and the plaza has been restored. Final devicing work and testing is underway to include public Wi-Fi.

  • The initial construction phase of the Edgewood, Allene, and PCM sites is complete. The sites are now awaiting permanent power to set the digital wayfinding kiosk. Then, final devicing work will get underway for public Wi-Fi.

  • Site work at the Jefferson/Lowery, Westside Trail Connector, and Enota sites are next in the queue to begin construction.

  • The process to get permanent power in place is underway at the Boulevard, Hill Street, Milton, New Realm, Ansley, 10th & Monroe, and Edgewood sites.

  • A new electrical pole will be placed adjacent to the trail to support the New Realm site just south of the Fourth Ward Offices. To do this work, access will need to originate at Willoughby Way on the Beltline. This work is being targeted for the week of November 30.

  • Installation of safety and silt fencing will occur around all construction areas as required.

  • No permanent blocking of pedestrians or trail will be done and any temporary moving of equipment through and in this area will utilize cones and a person for traffic control.
